Roosevelt Island Steam Plant Demolition

By emergency order of the New York City Department of Buildings (DOB), New York City Housing Preservation & Development (HPD) has begun demolition of the city's old steam plant located just south of Firefighters Field.

Below you can find the latest information from HPD and other agencies regarding the demolition work, including an overview of the project and information on environmental and safety procedures.

If you have any questions or concerns about the project, please email them to HPD at ridemolition@hpd.nyc.gov

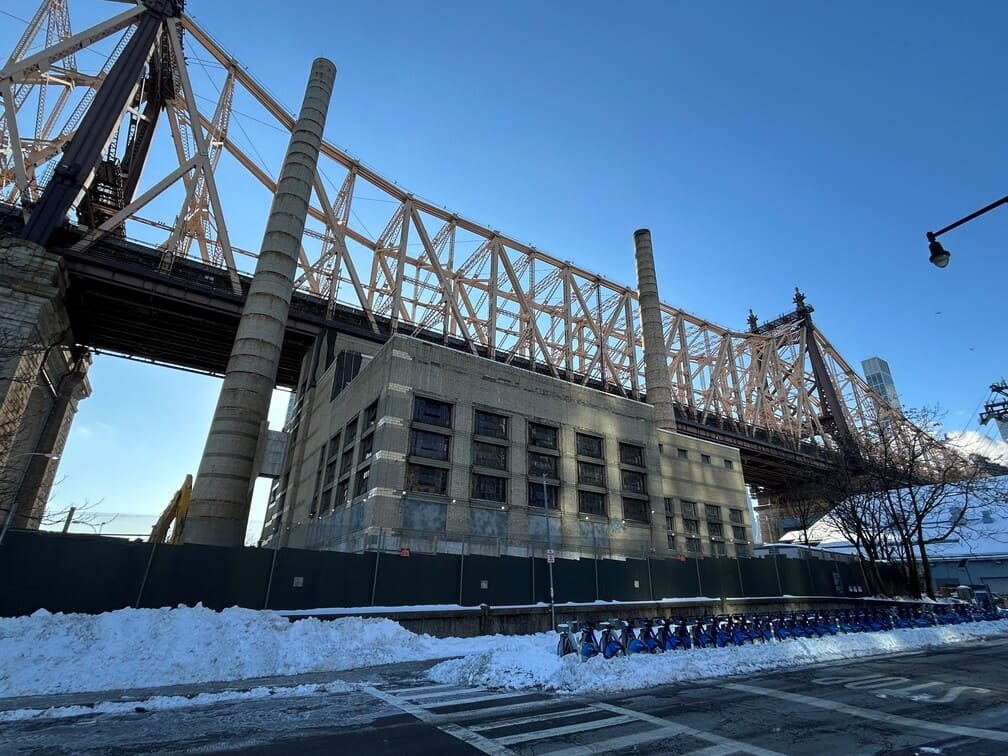

Roosevelt Island Steam Plant

HPD's Environmental and Safety Procedures Information

Environmental and Safety Procedures Memo

The Roosevelt Island Steam Plant, a structure built in 1939, was decommissioned in 2014. In July of 2024, the Department of Buildings issued an Emergency Order due to deteriorating conditions of the masonry and facade. Visible cracks and faulty masonry were observed on both the building and smokestacks. In 2025, the City, through the Department of Housing Preservation and Development, moved forward with a demolition plan in order to address the potential collapse of the smokestacks, seeking to safely remove the existing structure in response to the Emergency Order. HPD's Demolition Unit, which addresses structural conditions citywide when there are emergency orders from DOB, has contracted with a reputable licensed demolition contractor to complete the emergency work as quickly as possible in accordance with all federal, state and local laws.

HPD is committed to the safe and environmentally responsible demolition of the Roosevelt Island steam plant. We are ensuring that our contractor adheres to all federal, state, and local environmental regulations to safeguard the health and safety of Roosevelt Island residents related to the demolition.

We are implementing a multi-layered protective infrastructure to safeguard residents and existing infrastructure. Licensed environmental professionals will conduct any required remediation work. We are committed to transparent communication about timelines and safety measures as well as continuous monitoring throughout all phases of demolition.

HPD welcomes community feedback and remains committed to keeping Roosevelt Island residents informed throughout this project. We will continue to prioritize community well-being as we work to responsibly demolish this defunct facility.

Tramway Protection

  • Specialized roof protection system featuring three protective layers:
    • 2-inch high-density foam base layer
    • ½-inch plywood middle layer
    • Sandbag top layer for maximum impact resistance
  • Custom protective wood structures around roof exhausts and skylights with ventilation screening

Additional Safety Infrastructure

  • Sidewalk sheds to protect pedestrians
  • Scaffolding and safety netting around chimney stacks
  • Controlled demolition protocols to minimize environmental impact

Environmental Remediation Effort

HPD is working with experienced environmental contractors to ensure all contaminated materials required to be removed or addressed during demolition are handled according to the highest safety standards.

Oil Tank Removal

  • 8 underground oil tanks successfully dismantled and removed as of February 4
  • 4 remaining tanks scheduled for expected removal by end of February (weather permitting)
  • Soil samples collected and analyzed during tank removal
  • Contaminated and potentially contaminated soil properly isolated on-site in 6-mil polyethylene wrapping
  • Comprehensive removal plan in development in full compliance with federal, state, and local environmental regulations
  • Clean fill replacement planned following approved remediation procedures

Asbestos Abatement

All asbestos work will be performed by licensed asbestos abatement contractors, and independent, third-party environmental monitoring will be conducted by licensed air quality specialists in full compliance with DEP Title 15, Chapter 1, and DOL Industrial Code Rule 56.

Please note that all time estimates are subject to change based on weather, permitting, and other factors.

Phase 1: Preparation (Estimated Late February)

  • DOB permit application submitted and under final review
  • Make-ready work to remove obstructions, conducted under OSHA safety guidelines
  • FDNY permits obtained for necessary torch work with required fire watch protocols

Phase 2: Abatement (Estimated April)

  • Licensed abatement work to start following DEP approval
  • Continuous air monitoring throughout the process
  • Concurrent with controlled stack demolition

Controlled Demolition Process (Estimated April-May)

  • Hand demolition techniques to maximize control and minimize dust
  • Debris dropped through stacks as contained chutes
  • All debris that will be removed via truck will be securely covered during transport to prevent community exposure
  • Discussions with EDC may continue regarding option to barge

For more information on the Department of Environmental Protection's spill and response protocols, please visit Spill Response & Remediation FAQ - NYSDEC
